PSA Quick Tip: Billable hours equals 0 in Time Entry approval

On a billing Friday, when I consolidate the billing information for all my projects and send it to my accounting team, I saw a thing more closely to observe that for a few time entries done by the team the billable(hrs) column showed 0.00 and Billing Type shows Not Available.

fb1

Getting into the details was the only thing left rather than getting curious. The very first hit in my R&D took me to the right spot.

The Project contract type was my first guess and yes, it was of the type Fixed Bid. Hence, the time entry showed 0.00 in the Billable(hrs) column.

The reason is that the actuals for Fixed Bid project comes from the Milestone that is Invoiced and the actuals are actually not dependent on the time entries that are done by the Team.

But, in case there are some additional hours that are getting approved by the client that needs to be billed to the client apart from the milestone value, we need to do the following steps to get that included in the invoice.

Step 1:

Open the Project approval Entity as shown below

fb1

Step 2:

Select and open the record that you want to be invoiced to the customer for a Fixed Bid project.

fb2

Step 3:

Edit the following fields:

Billing Type: Chargeable

Billing hours: make it to X hours that you want to invoice.

Save the changes.

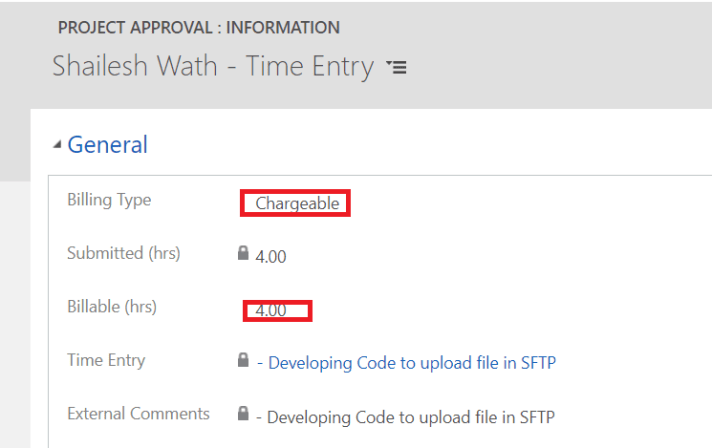

fb3

Step 4.

Now the time that is made charegable will be accrued as cost on the project.

Also, post that you need to open the invoice that has been generated by the milestone and edit it manually to add those CR hours in the Invoice.

You are done.

Leave a Reply

Fill in your details below or click an icon to log in:

WordPress.com Logo

You are commenting using your WordPress.com account. Log Out /  Change )

Google photo

You are commenting using your Google account. Log Out /  Change )

Twitter picture

You are commenting using your Twitter account. Log Out /  Change )

Facebook photo

You are commenting using your Facebook account. Log Out /  Change )

Connecting to %s
